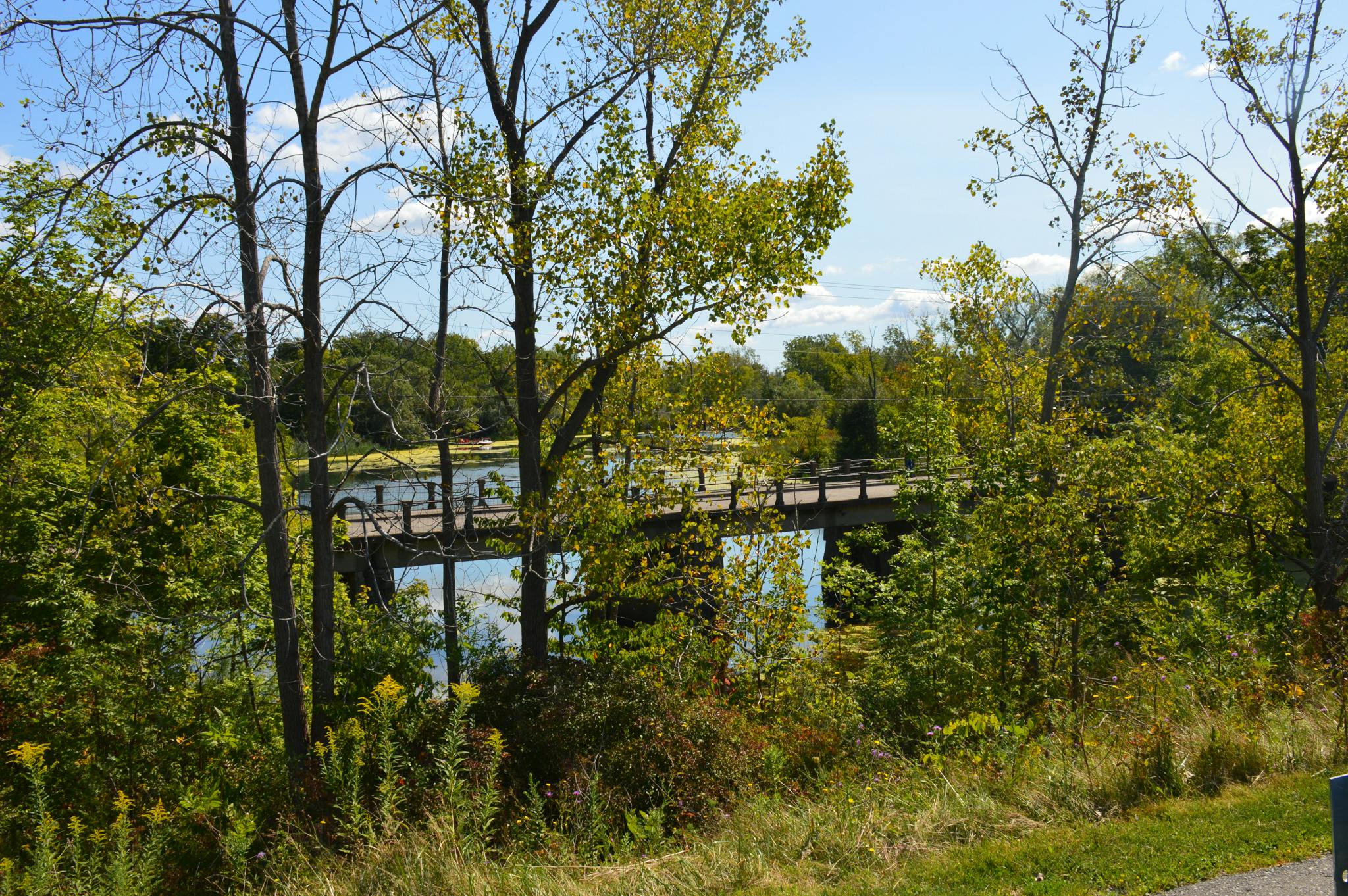

South Main Street Bridge Eco-Park Environmental Assessment

Share South Main Street Bridge Eco-Park Environmental Assessment on Facebook Share South Main Street Bridge Eco-Park Environmental Assessment on X (formerly Twitter) Share South Main Street Bridge Eco-Park Environmental Assessment on Linkedin Email South Main Street Bridge Eco-Park Environmental Assessment link

The City of Thorold initiated a Municipal Class Environmental Assessment (Class EA) study to address concerns related to the South Main Street Bridge and Pedestrian Linkage in the Port Robinson area. The Class EA was carried out as Schedule "B'' undertaking in accordance with the Municipal Class Environmental Assessment process, approved under the Ontario Environmental Assessment Act (1990).

McIntosh Perry Consulting Engineers Ltd. was originally retained by the City to facilitate the Class EA to address the need to provide a safe and reliable pedestrian linkage between South Main St. and Cross St. in the Port Robinson community. After the

The City of Thorold initiated a Municipal Class Environmental Assessment (Class EA) study to address concerns related to the South Main Street Bridge and Pedestrian Linkage in the Port Robinson area. The Class EA was carried out as Schedule "B'' undertaking in accordance with the Municipal Class Environmental Assessment process, approved under the Ontario Environmental Assessment Act (1990).

McIntosh Perry Consulting Engineers Ltd. was originally retained by the City to facilitate the Class EA to address the need to provide a safe and reliable pedestrian linkage between South Main St. and Cross St. in the Port Robinson community. After the Class EA, City of Thorold retained the services of RJ Burnside to create a conceptual rendering of a proposed Port Robinson Ecological Park (Eco-Park) at the South Main Street Bridge general location. The creation of an ecological park provides an opportunity to enhance an existing ecological habitat and an abandoned bridge currently used as a popular fishing hole/walkway connecting communities across an old canal waterway known for its wildlife. The Eco-Park design has an opportunity to reinforce the vision and character of the neighborhood while maintaining the ecological connection and environmental sensitivities.

The City of Thorold has commenced the detailed design phase for the South Main Street Bridge located in Port Robinson. The bridge is located between Cross St. (north) and South Main Street (south) over the former Welland River, now a segmented watercourse within Port Robinson in Thorold. The proposed design will be based on the mutually agreed “Preferred Design Concept Plan/3D Rendering” between the residents and the City. The detail design will also be in line with the display slides presented in the September 27, 2023 Public Information Centre that was held at the Port Robinson Community Centre.

Update (June 25, 2026)

At the City's request, the Ministry extended the deadline for resuming the Burial Site Investigation fieldwork until May 2026 to facilitate these funding discussions and scope modifications. Staff have prepared a draft work plan for the Burial Site Investigation and Stage 3 site-specific archaeological assessment, which has been circulated to both Ministries and participating Indigenous First Nations communities for review, and feedback. Further modifications are required.

During archaeological investigations undertaken as a part of the South Main Street Bridge detailed design, significant archaeological resources were identified within the northern limits of the project area. Consequently, the Ministry of Public and Business Service Delivery and Procurement (MPBSDP) and the Ministry of Citizenship and Multiculturalism directed the City to undertake a Burial Site Investigation and a Stage 3 site-specific archaeological assessment before the project can proceed.

In consultation with the MPBSDP's Burial Site Investigation Unit, the archaeological fieldwork was temporarily paused in December 2025 to provide the City with an opportunity to investigate potential external funding opportunities and refine the scope. At the city's request, the MPBSDP agreed to extend the timeline for restarting the field investigation until May 2026.

Staff have continued to refine the work plan and project scope to satisfy the MPBSDP requirements while minimizing the financial impact on the city. Through this process, two draft cemetery buffer options (20m and 30m buffer) were developed involving the designation of portions of city-owned lands as protected cemetery lands, thereby reducing the extent of archaeological excavation required.

Staff have also continued discussions with the MPBSDP Burial Site Investigation Unit regarding potential finding assistance through the undue financial burdens program. The MPBSDP has not confirmed whether funding will ultimately be available.

Ask Us!

Email
loader image
Didn't receive confirmation?
Seems like you are already registered, please provide the password. Forgot your password? Create a new one now.
  • Share Could I please get an update on the status of the Port Robinson South Main st./Eco park? Is the archeological dig commencing soon? If the dig is not completed yet is that going to continue to delay the project? If it is completed will the city be sharing the results of their finds? Thank you on Facebook Share Could I please get an update on the status of the Port Robinson South Main st./Eco park? Is the archeological dig commencing soon? If the dig is not completed yet is that going to continue to delay the project? If it is completed will the city be sharing the results of their finds? Thank you on X (formerly Twitter) Share Could I please get an update on the status of the Port Robinson South Main st./Eco park? Is the archeological dig commencing soon? If the dig is not completed yet is that going to continue to delay the project? If it is completed will the city be sharing the results of their finds? Thank you on Linkedin Email Could I please get an update on the status of the Port Robinson South Main st./Eco park? Is the archeological dig commencing soon? If the dig is not completed yet is that going to continue to delay the project? If it is completed will the city be sharing the results of their finds? Thank you link

    Could I please get an update on the status of the Port Robinson South Main st./Eco park? Is the archeological dig commencing soon? If the dig is not completed yet is that going to continue to delay the project? If it is completed will the city be sharing the results of their finds? Thank you

    PRCitizen asked over 1 year ago

    The detailed design for the Port Robinson South Main Street/Eco Park Bridge is currently underway. Archaeological digs and additional coordination efforts are ongoing. The city is collaborating with its engineering consultant and the Ministry of Citizenship and Multiculturalism (MCM) to ensure all archaeological work is properly addressed. Once the detailed design and all necessary fieldwork are completed, the city will provide an update on the project webpage on Thorold’s Let’s Talk Thorold platform.

  • Share I know that there was an archeological dig that happened near the bridge this fall. It has been more than a month since their return yet there is still a container of their tools in place. Can you tell me if they have completed their work? If not, how long is this going to delay the rest of the work? I asked the workers if their findings would be made public and they said that it was up to the city to do that. When they are finished will the city share the findings with the public? Thank you on Facebook Share I know that there was an archeological dig that happened near the bridge this fall. It has been more than a month since their return yet there is still a container of their tools in place. Can you tell me if they have completed their work? If not, how long is this going to delay the rest of the work? I asked the workers if their findings would be made public and they said that it was up to the city to do that. When they are finished will the city share the findings with the public? Thank you on X (formerly Twitter) Share I know that there was an archeological dig that happened near the bridge this fall. It has been more than a month since their return yet there is still a container of their tools in place. Can you tell me if they have completed their work? If not, how long is this going to delay the rest of the work? I asked the workers if their findings would be made public and they said that it was up to the city to do that. When they are finished will the city share the findings with the public? Thank you on Linkedin Email I know that there was an archeological dig that happened near the bridge this fall. It has been more than a month since their return yet there is still a container of their tools in place. Can you tell me if they have completed their work? If not, how long is this going to delay the rest of the work? I asked the workers if their findings would be made public and they said that it was up to the city to do that. When they are finished will the city share the findings with the public? Thank you link

    I know that there was an archeological dig that happened near the bridge this fall. It has been more than a month since their return yet there is still a container of their tools in place. Can you tell me if they have completed their work? If not, how long is this going to delay the rest of the work? I asked the workers if their findings would be made public and they said that it was up to the city to do that. When they are finished will the city share the findings with the public? Thank you

    PRCitizen asked over 1 year ago

    The work at the Main Street Bridge is not complete yet. The schedule is undetermined at this point, related to weather and lab results. Yes, the findings will be made public when the results are in. You can follow this webpage for any updates that will be posted in the future.
